The stormwater permit appeal
Asks the Hearing Board to revoke the permit coverage for the data center's first phases, or to require an individual permit before more earth is disturbed.
Legal Update
Judge sets November 13 hearing on the Middlesex families' spot zoning challenge
Permits
The developer used Governor Shapiro's Permit Fast Track Program to speed up its permits. Rather than get its own stormwater permit, which controls runoff and erosion during construction, the developer kept amending a housing permit granted in 2018. After four amendments, it covers the site planned for 16 hyperscale data centers. No outside party has ever assessed the environmental impact of the whole project.
New here? PAX-1 is a $15 billion, 16-building data center campus going up near Carlisle. Start with the basics or read the FAQ
The permit

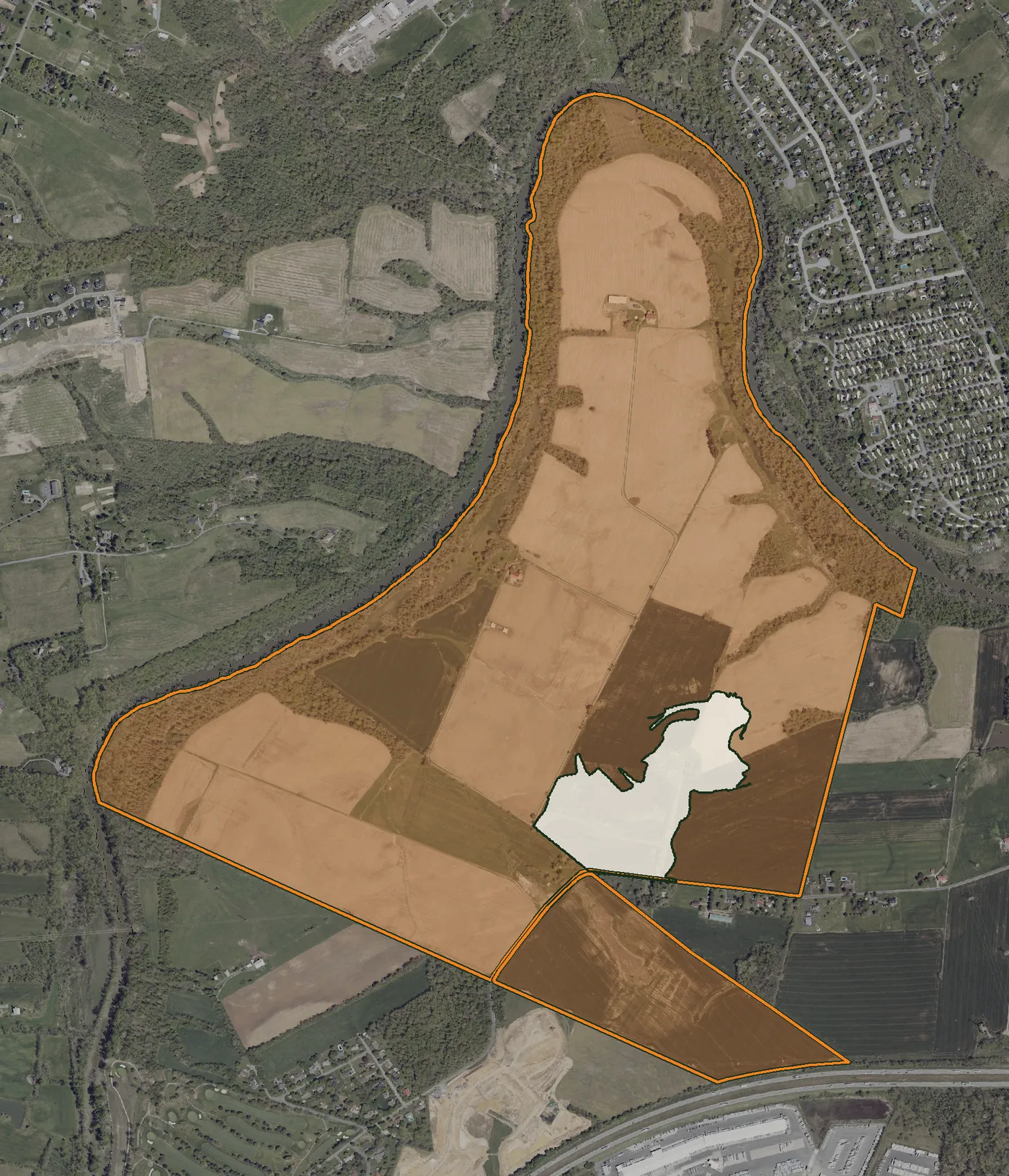

Traced from the permit's own plans: the Cumberland Knoll erosion control plan, and the permit boundary sheet from the December 2025 amendment. Aerial imagery: USGS and USDA.
PAX-1 is building on a permit first issued for Cumberland Knoll, a 58-home subdivision on 15.3 acres, with a permit area of 36 acres. Today it covers 693 acres, 19 times the area.
An inch of rain on the 16 roofs alone comes to more than 1.5 million gallons of runoff for this permit to handle.
The developer's building sizeUSGS: an inch of rain on an acreCheck our math on the runoff
How it stretched
In July 2025, the Cumberland County Conservation District, which approves stormwater permits here, told the state Department of Environmental Protection (DEP) that the project would bring “4+ amendments throughout the project” and that tracking them would be “extremely difficult and confusing.” The District approved every one. View the quote in our appeal
A-1
August 5, 2025
The permit passes from the old residential developer to Carlisle Development Partners, the developer's company.
A-2
September 8, 2025
Approved for a stone laydown yard serving PPL's substation work, though the District's own table takes impervious cover, ground that rain can't soak into, from 0.57 acres to 13.77. No notice is published.
A-3
December 30, 2025
Approved seven days after the District called the application complete and said technical review would begin. The permit site grows from 36 acres to 693, and the project description now reads a 693-acre data center.
A-4
May 18, 2026
Approved thirteen days after the developer responded to the 24 deficiencies still open in the stormwater plans.
82
technical deficiencies county reviewers found in the Phase 1A and 1B stormwater plans in March 2026. In May, 21 were still not adequately addressed, and 3 new ones had been added.
92
documents in the Right-to-Know response that reached a resident on May 18, 2026. It was the first notice anyone outside the agencies had of what the old permit now covers.
The whole project
The stormwater permit is only one of the approvals PAX-1 needs. DEP's permit tracker lists 21 for the project as of September 23, 2026. Each one is reviewed on its own terms.
8 issued
5 pending
8 not yet submitted
DEP, through the county Conservation District
Amended four times
Written for 58 homes and stretched to cover the campus. DEP's tracker lists a fifth amendment as pending and three more as not yet submitted.
DEP
4 issued, 2 pending
Six general permits for utility lines, a road crossing and repairs, applied for one at a time since January 2025. DEP lists one more stream and wetland permit as not yet submitted.
DEP
Pending
In January 2026 DEP required full sewage planning for the campus's industrial wastewater, plus a separate permit for the cooling-water pump station. The planning module reached DEP in September 2026.
DEP
Not yet submitted
The plan approval and the operating permit a campus of diesel generators needs.
DEP
Not yet submitted
For the generators' diesel. The developer's engineer said each generator will have its own tank.
Susquehanna River Basin Commission
Needed before it runs
The Township's ordinance requires the commission's approval for a project that consumes 20,000 gallons a day or more, and PAX-1 is set to draw up to 400,000. In May 2026 the commission said PAX-1 is expected to consume at least 20,000 gallons a day for part of the year, that it needs the commission's approval before operating, and that no application had been filed.
State Historic Preservation Office
Adverse effect
It found the project will have an adverse effect on the view from the Appalachian Trail, still unresolved as of May 2026.
Required by the Township's zoning
By the developer's engineer
The only full assessment of the whole project. It was written by LIVIC Civil, whose principal, Justin Ross, is also chief operating officer of Pennsylvania Data Center Partners, one of the two companies behind PAX-1. In August 2025 the Township's engineer lost Skelly and Loy as its reviewer: they “have a conflict with Powerhouse,” the other company. At the May 6, 2026 meeting, asked whether the Supervisors had known of Ross's affiliation, Chairman Donald Geistwhite said, “I just learned this a couple of days ago.” They approved three plans that night.
View the emailsSee the company's pageView the reviewer emailWatch him name both rolesWatch the chairman's answer
On the record
Blasting and earthmoving were underway before the land development approvals were issued. DEP has cited two violations on the site, and the county Conservation District two more.
August 7, 2025
In July 2025 a DEP inspector found a sewer line for the Cumberland Knoll subdivision already installed through a wetland on one of the parcels, with no Chapter 105 permit, the state permit for building in streams and wetlands. DEP issued a notice of violation to Club Road Properties, Cumberland Knoll's developer, and the excavator, citing the Clean Streams Law. The data center developer, which bought the parcel that month, agreed to apply for the permit after the fact. The line went in first, and the permit came later.
June 15, 2026
140.5 dBLagainst a limit of 133
A blast at the site measured 140.5 dBL at a home on Sassafras Lane, against a state limit of 133 for airblast, the pressure wave a blast sends through the air. Airblast is measured differently from everyday noise, so these numbers do not compare to the 70 dBA noise limit. DEP cited the blasting contractor on June 24 for “failure to control airblast.” The developer's PAX-1 website still says DEP inspections “confirmed that measures taken exceed the minimum requirements.”
August 5, 2026
Twenty days after DEP said it saw no pattern of violations, a Conservation District inspection under the permit's fourth amendment cited two more: erosion controls not maintained, with filter socks overtopped and undercut, and bare ground not stabilized. The report says the violations it notes “constitute unlawful conduct” under the Clean Streams Law.
Article I, Section 27, Pennsylvania Constitution
“The people have a right to clean air, pure water, and to the preservation of the natural, scenic, historic and esthetic values of the environment. Pennsylvania’s public natural resources are the common property of all the people, including generations yet to come. As trustee of these resources, the Commonwealth shall conserve and maintain them for the benefit of all the people.”
The Pennsylvania Constitution gives every person the right to clean air, pure water, and the natural beauty around them. It makes the government a trustee, bound to protect these things for everyone, including the generations not yet born.
Trustee is the key word: the government is not free to hand these resources away. In 2013 the Pennsylvania Supreme Court ruled that a government body has to weigh the environmental impact before it acts, not after.
DEP carries the same duty as trustee. Our appeal argues that DEP and the county Conservation District approved 300 acres of earthmoving, draining toward the Conodoguinet Creek, without the showings the rules require on how much runoff it would send and how clean it would be, and so failed that duty.
What we're doing
We took all four amendments to the Environmental Hearing Board. If the permit is pulled or narrowed, construction could stop or slow while the developer starts over with the right permit and a real public process.
Asks the Hearing Board to revoke the permit coverage for the data center's first phases, or to require an individual permit before more earth is disturbed.
Fund the fight
The stormwater permit appeal runs on briefs, expert witnesses, and filing fees.
