Skip to content

Legal Update

Judge sets November 13 hearing on the Middlesex families' spot zoning challenge

Impacts

In one decision, the Supervisors nearly doubled Middlesex's industrial land.

Check our math on the industrial land

They changed the nature of this community forever, without weighing what it means for the residents, livestock, wildlife and visitors who share it. PAX-1 puts 16 data center buildings on 693 acres of farmland beside the Conodoguinet Creek, a third of a mile from the Appalachian Trail.

Where it is

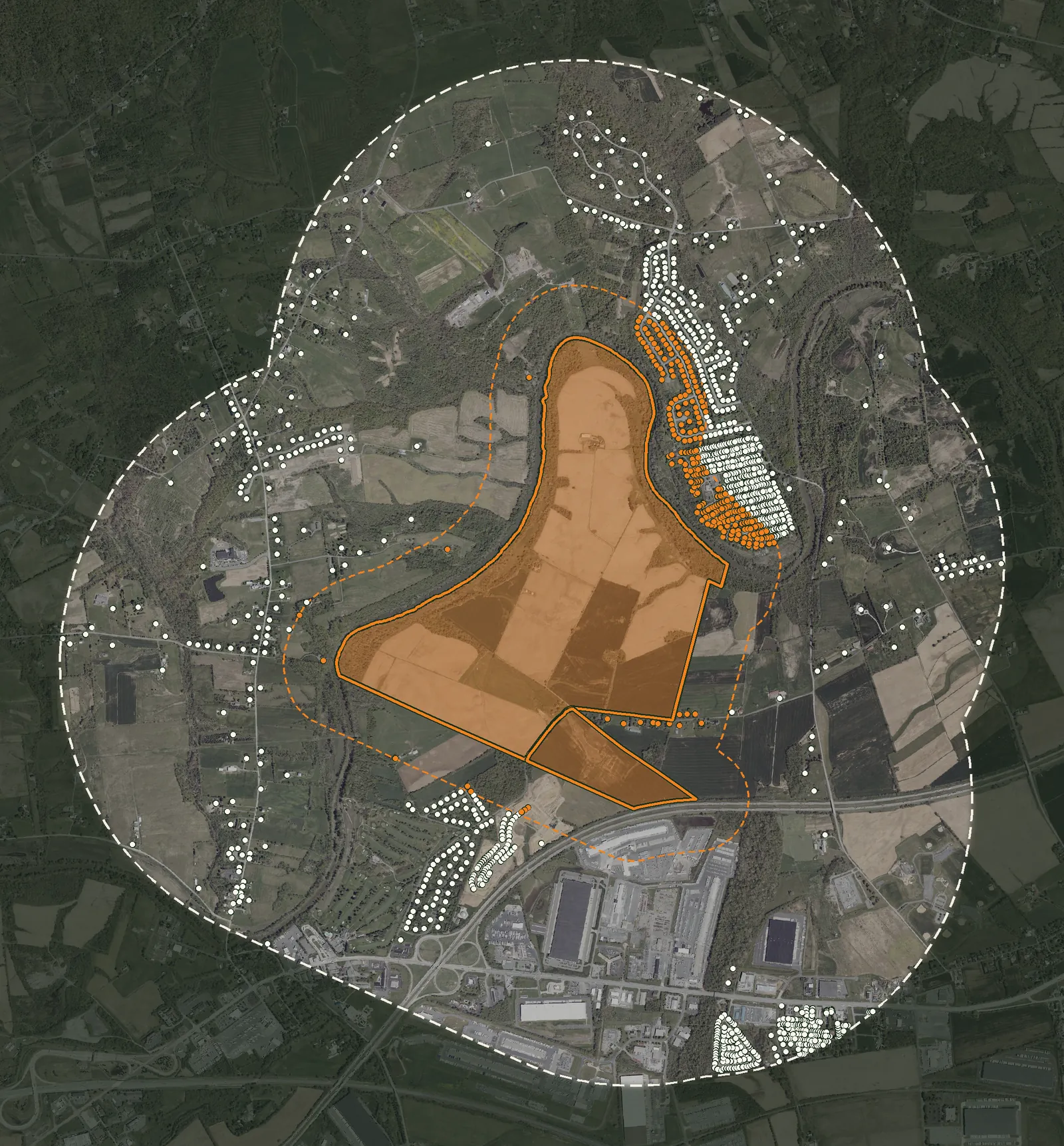

PAX-1 sits in the middle of all of us.#

An aerial photo centered on the PAX-1 site, outlined in orange, with dashed lines 1,000 feet and one mile out from it. 1,333 dots mark the homes inside the mile, crowded into the neighborhoods across the creek to the northeast and along Country Club Road to the south; the 260 inside 1,000 feet are orange.

A home within 1,000 feetA home within a mile

  1. 1.9×

    The land is zoned for neighborhoods. PAX-⁠1 will still nearly double Middlesex's industrial land, adding 693 acres to the 784 there now. Check our math on the industrial land

  2. 260

    homes within 1,000 feet of the site, about the length of three football fields. The nearest is about 80 feet from the property line.

  3. 1,333

    homes within a mile of the site, in neighborhoods and on farms on both sides of the Conodoguinet Creek. This is where we live.

  4. 14%

    of the homes in the mile are in Silver Spring Township, whose residents may not speak at Middlesex's meetings Watch a neighbor turned away

  5. 39%

    of all the homes in Middlesex Township are within the mile

Homes from Cumberland County's 911 address records. Industrial land from its 2020 land-use survey plus two warehouses the survey missed. Buildings, drives, generator yards, substations and the laydown yard from the developer's own plans. Aerial imagery: USGS and USDA.

Check our math on the homesThe developer's site planThe county's land-use survey

“I understand that Country Club Road is not gonna be a good place to live for the next five years.”

Supervisor Phil Neiderer, Board of Supervisors meeting, July 1, 2026. Watch it

How close are you?

See how far your home is from PAX-1, and what to expect there.

We don't save addresses or locations.

The costs

What does this cost us?#

  1. Farmland

    615 acresrated prime farmland or farmland of statewide importance

    Miles of concrete go down on some of our best farmland.#

    That's 9 acres in 10 of the site.

    USDA's soil survey rates 615 acres of the site as prime farmland or farmland of statewide importance.

    Check our math on the farmlandWhat the classes mean

    Two historic farms on the site are coming down.

    The state found an adverse effect on two farms on the site that are eligible for the National Register of Historic Places, and in May it accepted mitigation as resolving it. By July 31, the two brick farmhouses had likely been removed and the barns were being torn down.

    The state on the farmsRead the July 31 minutes

    More on what the developer paid

    The developer paid $44 million for the land.

    The developer's company paid $44 million for the four parcels that make up the site, in two deeds recorded on July 15, 2025.

    View the $30 million deedView the $14 million deed

  2. Construction

    6 yearsof construction, from March 2026 to spring 2032

    View the schedule

    Before it ever runs, years of blasting, trucks and early mornings.#

    One blast broke the state's limit.

    Blasting was under way by April, when residents told the Supervisors they hadn't heard the warning siren. On June 15, one blast reached 140.5 decibels of airblast at a home, against the state's limit of 133, and the state Department of Environmental Protection (DEP) cited the blasting contractor. Airblast has its own scale, so these numbers don't compare with noise limits.

    Read it in the April 1 minutesView the DEP report

    Neighbors here are living with it now.

    Since construction began, neighbors have described beeping from six in the morning, dust on everything, and blasts that shake their homes.

    What they've told the Township

    More on the work hours, home inspections, and the schedule, and a note on Virginia

    Work is allowed six days a week, from 6 a.m.

    The Township says existing approvals allow construction Monday through Saturday, generally from 6 a.m. to 7 p.m., and that it lacks the authority to restrict that schedule now. Its zoning officer confirmed in July that its ordinances set no construction hour limits.

    Read it in the June 3 minutesRead it in the July 1 minutes

    In April, the Township said home inspections weren't legally required.

    The Township said inspections before blasting “are not legally required but are being offered by contractors.” The approved plans for the first campus, revised in June, add that “a pre-blast survey shall be completed.”

    Read it in the April 24 minutesView the plan's note

    The developer's schedule runs from March 2026 to spring 2032.

    In March 2026, Supervisor Phil Neiderer said the work then under way was mainly relocating a water main along Country Club Road. The developer's schedule grades the roads and substations for all three campuses in 2026, then builds the campuses one after another until spring 2032.

    View the March 27 minutesView the schedule

    Virginia's legislative auditors found that a large data center site can take as long as seven years to build, with thousands of workers and substantial truck deliveries, and that nearby residents report loud construction noise and traffic.

    Virginia on construction

  3. Water

    146 milliongallons of water allocated a year

    In place of farmland, a massive compound stands, devouring our water.#

    It is allocated as much water as 2,367 homes use.

    The municipality has allocated the campus 400,000 gallons of water and 273,000 gallons of sewer capacity a day. Over a year, the water comes to 146 million gallons. Engineers say that much water equals what 2,367 homes use.

    The water PAX-1 is allocated2,367 homes' worth
    Every home within a mile of it1,333 homes

    Check our math on the waterView the meeting notesPennLive on the water

    That's most of what the authority's Middlesex customers use now.

    The water authority's December 2025 memo puts the average demand of its customers in Middlesex at 560,000 gallons a day, not counting the 660,000 it sends on to North Middleton Township. PAX-1's allocation is 400,000.

    The authority's current use

    More on the peak demand, new water sources, the river basin approval, private wells, and well testing

    The developer's consultant put the peak at 3 to 4 million gallons a day.

    That consultant wrote in September 2025 that the campus could need 3 to 4 million gallons a day at its peak, “the vast majority, if not the entirety” of it from “groundwater supply wells.” The Township's approvals now bar wells on the site, and the developer has agreed not to ask for more than 400,000 gallons a day “based on” the water authority's “current capacity.”

    View the consultant's reportView the no-wells conditionView the water cap

    The water authority says it will need new sources.

    In a December 2025 memo that counts the campus, the Middlesex Township Municipal Authority says new sources “will be necessary to meet future MTMA customer demands.” In September 2026 the Susquehanna River Basin Commission tabled the authority's application for a second well. Reviewing it in April, the commission's hydrogeologist had written that the system's capacity “may be close to, or even a little less than, the projected demand,” a projection drafted with 400,000 gallons a day for the data center.

    View the authority's memoRead the Federal Register noticeView the commission's reviewView the authority's projection

    It needs a river basin approval it had not applied for.

    In May 2026 the commission confirmed that PAX-1 needs its own approval before operating, and that no application had been filed.

    View the email

    Some of the closest neighbors rely on wells.

    About 16 of the 260 homes within 1,000 feet of the site, 11 of them on Country Club Road, are likely on private wells. The other 244 are likely on the authority's public water.

    Check our math on the wells

    The state's blasting rules require no well survey.

    Pennsylvania's rules for construction blasting require no survey of nearby wells. The Township's engineer asked twice for one, in October and December 2025. In a side letter approved on September 2, 2026, the developer agreed to test wells within 1,500 feet “before further blasting,” and to repair or replace any that blasting harmed, for owners who sign a separate agreement.

    Read the state's blasting rulesView the first requestView the second requestView the side letter

  4. Power and our bills

    9×the electricity of all homes in Cumberland County

    Our bills rise as we compete for what's left.#

    1.35 gigawatts, and a claim it will offset our rates.

    The developer's announcement puts PAX-1 at 1.35 gigawatts of capacity, expandable to 1.8. Its PAX-1 website says the project “will offset consumer electrical rates for the first time in decades.”

    Check our math on the electricityRead the announcementSee the developer's site

    Data centers added $29.4 billion to the grid's capacity costs.

    The independent market monitor for PJM, which runs our regional grid, found that data centers added $29.4 billion to the region's capacity costs, the price of keeping enough power plants ready, for June 2025 through May 2029. That's nearly half of all capacity charges in those four years. In PPL's rate case, the vice chair of Pennsylvania's utility commission said large new loads account for 55 percent of the rise in capacity prices, and “those costs have begun to flow down to customers' bills.” PPL says higher capacity prices have added about $20 a month to its average home's bill.

    Read the reportThe monitor's July reportThe PUC vice chair's statementSee PPL's page

    More on the substation and a note on Virginia

    The substation is set to connect in June 2027.

    The developer's engineer told the Supervisors in March 2026 that the new PPL substation on the site is scheduled to connect to the grid in June 2027.

    View the minutes

    Virginia's legislative auditors estimated that data center growth could raise a typical Dominion Energy household's generation and transmission costs by $14 to $37 a month by 2040, not counting inflation.

    Read the Virginia report

  5. Noise

    70 dBAallowed at the property line, at any hour

    The peace of the Conodoguinet Creek is replaced by 24/7 mechanical noise.#

    The developer's model gives nearby homes the hum a Virginia neighborhood still lives with.

    In dBC, which more accurately captures low-frequency noise than dBA, the developer's April study gives 14 of the 16 homes it modeled 58 to 64. A noise engineer measured 60 to 63 at night outside homes near Amazon's data centers at Great Oak, Virginia, where in 2025 the neighborhood was still “plagued by a low-frequency roar.”

    View the study's home resultsPrince William's night measurementsPrince William Times on Great Oak in 2025

    Our zoning holds a solar farm to 50 decibels. A data center gets 70.

    Both limits are measured in dBA at the property line, and a wind turbine gets 55. The data center's 70 “does not apply during a time of power outage.” The same law gives a refrigerated warehouse a limit on low hum, measured in dBC, a penalty for a whining tone, and a noise study the Township can order once it runs. The data center rule has none of these.

    View the solar limitView the wind limitView the noise limitView the warehouse rules

    More on the homes it didn't model, the unchecked study, and the louder June plans, and notes on health, children, farm animals, and Virginia

    It modeled no home past 3,800 feet.

    The study's farthest modeled home is 3,800 feet from a building, and it says homes farther out “can reasonably be expected to experience equal or lower sound levels.” By our count, 922 of the 1,760 homes within 2 miles of the buildings are past that point.

    Check our math on the homesRead what it says about homes farther outSee where it modeled homes

    The Township's consultant could not check the noise study.

    The Township's rules “don't specifically address low frequency,” its zoning officer said. In August 2026 the Township's review consultant still could not check the study's model, because the developer would not share the specifications of the generators and air handlers without naming its tenant.

    View the Township's reviewWatch the low-frequency answerWatch the review consultant

    Its louder June plans give no level at any home.

    The June update lists more and louder equipment and raises each large generator's rating by 10 decibels, which the developer's own study says most people hear as about twice as loud. It maps only where sound would top 70 dBA.

    View its June equipment tableView the June generator levelView the study on 10 decibelsView its June results

    To protect sleep, the World Health Organization advises no more than 45 decibels outside homes at night and 30 inside. It adds that low-frequency noise, “for example, from ventilation systems, can disturb rest and sleep even at low sound pressure levels.”

    Read the 1999 WHO guidelinesRead the 2016 review

    The American Academy of Pediatrics says environmental noise can affect children's learning and sleep.

    Read the pediatricians' statementRead the 2018 WHO guidelines

    Sudden loud noise stresses cattle, and older studies found it can cut their milk.

    See the county's farm censusRead the livestock noise reviewRead the dairy welfare standard

    Virginia's legislative auditors found that data centers' low-frequency noise “is not fully captured” in A-weighted decibels, the usual measure, so it rarely breaks noise limits. They advised localities to “prohibit the constant low-frequency noise of data centers from reaching residential areas.”

    Read the Virginia reportRead the Virginia reportSee Prince William's ordinance

  6. The Appalachian Trail

    1/3 milefrom the Appalachian Trail

    View the Park Service letter

    Sixteen buildings, about 80 feet tall, scar the scenic beauty of the Appalachian Trail.#

    The state found it will block the Trail's views.

    In January 2026 the State Historic Preservation Office disagreed with the developer's finding of no adverse effect. It found the project will have an adverse effect on the Appalachian Trail, by blocking the Trail's views of open space. The Trail Conservancy counts upwards of 150,000 visitors to this part of the Trail each year.

    View the determinationRead the statement

    A wind turbine must stay 2,500 feet from the Trail. A data center doesn't.

    Middlesex's zoning keeps every wind turbine at least 2,500 feet from the Appalachian Trail. Its data center rules set no distance from the Trail at all.

    View the wind turbine setback

    More on the viewpoint the study skipped, the evergreen screen, and the Trail Conservancy's opposition

    The developer's view study left out the closest Trail viewpoint.

    The Appalachian Trail Conservancy says the developer's view study skipped the viewpoint nearest the site, less than 0.3 miles away. From there, it says, the development would be in view along about 3,000 feet of the Trail.

    View the Conservancy's February letter

    The state rejected the developer's screen of 100 evergreens.

    In March the state rejected the developer's plan to plant 100 evergreens along the Trail corridor, because the trees could themselves block historic views of the surrounding farmland. Virginia's legislative auditors found screening of limited value: “Newly planted trees take decades to grow.”

    View the follow-up letterVirginia on screening

    The Appalachian Trail Conservancy came out against it.

    The Appalachian Trail Conservancy publicly opposed the project on May 6, 2026, the day the Supervisors first approved plans for data center buildings.

    Read the statement

  7. Generators and air

    Fthe county's air grade for short-term particle pollution

    582 diesel generators pollute the air.#

    The developer's own noise study counts 582, more than ten times the average Virginia site.

    Its equipment table lists 566 large backup generators of 2.5 megawatts each and 16 smaller ones of 600 kilowatts. Virginia's legislative auditors counted 54 permitted generators at the average data center site there.

    View the equipment tableVirginia's average site

    Our air already gets an F.

    The Clean Air Board of Central Pennsylvania told the Supervisors that Cumberland County's air already gets an F from the American Lung Association for short-term particle pollution.

    See the county's gradesWatch the Clean Air Board

    More on testing, outages elsewhere, air permits, and the grid, and notes on health and Virginia

    Testing is “a daily activity,” and the schedule won't be published.

    The developer's engineer calls generator testing “a daily activity,” and its general counsel says the tenant will not publish the schedule.

    Watch “a daily activity”Watch the testing answer

    Outages elsewhere have run them for a day or more.

    In July, a power failure at Vantage's 18-acre campus in Sterling, Virginia, ran its backup diesels for nearly 24 hours, and the state's environmental agency told residents it had “no regulatory authority to stop these actions.” Dominion has warned Loudoun County's supervisors that backup generator use may become more frequent.

    Watch WUSA9's reportWJLA on Sterling's generators

    No air permits had been applied for by September 23.

    The developer's engineer told the Supervisors in July 2026 that each generator will have its own diesel tank, with no central storage. As of September 23, 2026, DEP's permit tracker listed the air quality permits and the storage tank permitting as not yet submitted.

    See the trackerWatch the fuel answer

    They don't only run for tests and outages.

    In May 2026, during a heat wave, the U.S. Department of Energy authorized PJM, our regional grid operator, to direct data centers onto their backup generators as a last resort before cutting power to customers. On July 2, PJM told the Department it had come close to doing so. Three times since 2024, PJM's records show, 1,500 to 3,900 megawatts of “large computational load” switched onto backup generation during line faults that cleared normally.

    Read the federal orderPJM's July 3 letterPJM's review of the transfers

    The World Health Organization's cancer agency found in 2012 that diesel exhaust causes lung cancer. After studying the data centers around Quincy, Washington State's environmental agency advised local planners to avoid zoning homes near clusters of them.

    Read the WHO cancer agency's findingRead the Washington study

    Virginia Commonwealth University researchers mapped the backup generators at 138 Northern Virginia data centers. Most run them rarely, but some already emit 30 percent or more of what their permits allow, and some clusters out-pollute a nearby power plant.

    Read about the VCU studyRead the Virginia report

  8. Light

    Its plans keep the lights on all night.#

    The plans keep the lights at the same levels after hours.

    The plans for the first campus say after-hours lighting “will remain at levels illustrated on the lighting plan,” though the developer's engineer told the Supervisors in August that most lights would be off or dimmed.

    View the plans' lighting noteWatch “dimmed to that lower standard”

    The Park Service and the Trail Conservancy both raised the lighting.

    The National Park Service wrote that the campus lighting “will likely impact the appreciation of dark night skies/stargazing in the Trail's protected corridor.”

    View the Park Service letterView the Conservancy's letter

    More on PPL's lights

    The dark-sky rules don't cover PPL's part of the site.

    The developer's agreement for the first campus, read aloud on August 19, requires dark-sky lighting on its land but not where PPL is in charge. The Supervisors approved it on September 2. Supervisor Neiderer said in May that PPL, as a public utility, is not bound by the Township's zoning or its lighting rules.

    Hear the lighting termsWatch Supervisor Neiderer on PPL

Near other data centers

“Data centers are industrial facilities that are largely incompatible with residential uses.”#

Virginia's legislative auditors, December 2024

Read the Virginia report

Residents living near 30 data centers across 19 states describe how the noise, the lights, the generators and the blasting have impacted their lives. Most of those sites are smaller than PAX-1.

What it's like to live next to a data center

Where this leads

In the end, we trade our heritage and our children's future for industry. We become a data center town.#

That label is a one-way door that future generations inherit whether they want it or not.

More land has already been proposed for data centers.

  • Middlesex

    214 acres

    By December 2025, a property owner had asked Middlesex to stretch the Data Center Overlay onto 214 more acres along Harrisburg Pike, most of it farmland. The county planning department recommended disapproval. In February 2026 the Supervisors put new data center zoning on hold until the Township adopts a new comprehensive plan. The hold does not undo PAX-1's zoning.

    View the county reviewThe county on the farmlandView the minutes

  • Monroe Township

    144 acres

    In April 2026, the partnership behind PAX-1 asked Monroe Township to hear its plans for a possible data center on 144 acres it had secured there.

    The letter to MonroeThe Sentinel on Monroe

What we're doing

The zoning and the permits are how we stop it.#

The rules that let PAX-1 in were drafted by the developer's attorney, and it's being built on a stormwater permit first written for 58 homes. We're challenging both.

  • In county courtCumberland County Court of Common Pleas

    The spot zoning challenge

    Asks the court to strike the overlay as spot zoning, as a violation of the Environmental Rights Amendment, and as an abuse of discretion.

    Every step and filing

  • In county courtCumberland County Court of Common Pleas

    The land use appeals

    Asks the court to reverse the Supervisors' plan approvals and send the plans back to them to be denied.

    Every step and filing

  • Before a state boardPennsylvania Environmental Hearing Board

    The stormwater permit appeal

    Asks the Hearing Board to revoke the permit coverage for the data center's first phases, or to require an individual permit before more earth is disturbed.

    Every step and filing

Fund the fight

Lawyers stop bulldozers.

The spot zoning challenge, the land use appeals, and the stormwater permit appeal run on briefs, expert witnesses, and filing fees.

Fund the Fight100% goes to the legal fund.
